• Project Overview
  • Construction/Gallery
    • Stage 1A
    • Stage 1B
    • Stage 2
    • Stage 3 & 4
    • Stage 5
    • Stage 6
    • MP 61.5
    • Connections
  • Project Contacts
  • Planning and Design
  • More
    • Project Overview
    • Construction/Gallery
      • Stage 1A
      • Stage 1B
      • Stage 2
      • Stage 3 & 4
      • Stage 5
      • Stage 6
      • MP 61.5
      • Connections
    • Project Contacts
    • Planning and Design
  • Project Overview
  • Construction/Gallery
    • Stage 1A
    • Stage 1B
    • Stage 2
    • Stage 3 & 4
    • Stage 5
    • Stage 6
    • MP 61.5
    • Connections
  • Project Contacts
  • Planning and Design

Sterling Highway MP 45-60 Project

Sterling Highway MP 45-60 ProjectSterling Highway MP 45-60 ProjectSterling Highway MP 45-60 Project

FOR IMMEDIATE TRAVEL UPDATES

Alaska 511

JOIN US!

CONSTRUCTION OPEN HOUSE - wEDNESDAY, MAY 13, 2026

PROJECT OVERVIEW

The Sterling Highway MP 45-60 project aims to bring the highway up to current standards for a rural principal arterial to efficiently and safely serve through-traffic, local community traffic, and traffic bound for recreation destinations in the area.

project area map

Click Here to View Project Area Map

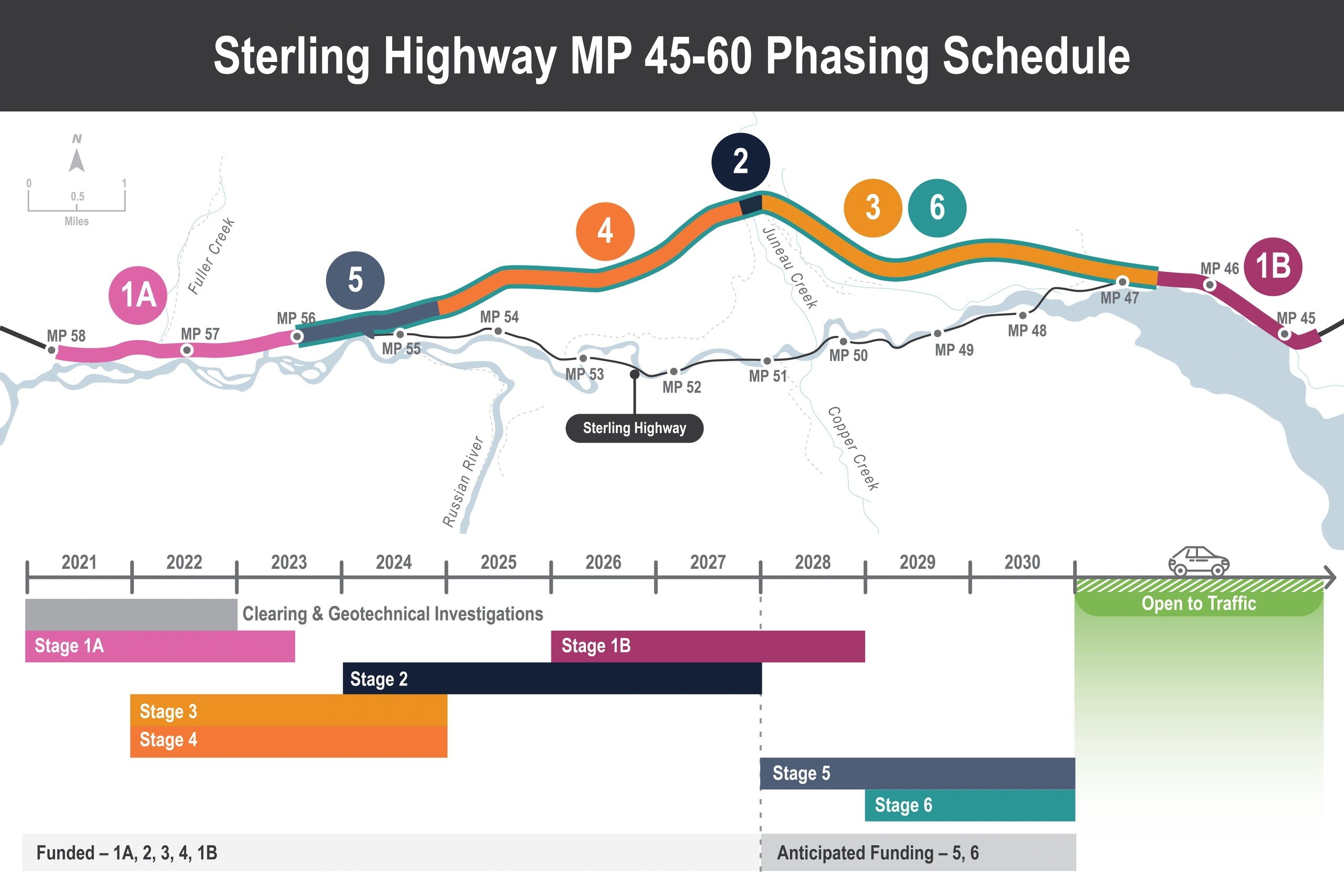

CONSTRUCTION PHASING PLAN AND SCHEDULE

The project's current plan and schedule proposes six (6) stages. The figure illustrates the construction phasing approach that will be followed based on available funding and if the State of Alaska Department of Transportation & Public Facilities (DOT&PF) is successful with securing funds outside the traditional methods. The anticipated number of construction seasons are presented in the timeline for each stage.


  • Stage 1A, construction was completed in 2023
  • Stages 3 and 4, which included pre-liminary earthwork and drainage, was completed in 2025
  • Stage 2, the Juneau Creek Bridge, is currently under construction
  • Stage 1B is currently under construction
  • Stages 5 and 6, are anticipated to achieve 95% design in early 2027
  • Completion and opening of the Juneau Creek Alternative is predicted to occur in 2030


These dates are dependent on the timing of funding allocations, as project funding is obtained the expected completion and opening date will be adjusted.

Project Video

Full Project Video - August 28, 2024. Video provided by Bean Creek Media, LLC.


Copyright © 2026 Sterling Highway MP 45-60 Project - All Rights Reserved.


Powered by

This website uses cookies.

We use cookies to analyze website traffic and optimize your website experience. By accepting our use of cookies, your data will be aggregated with all other user data.

Accept
